The first belt ran perfectly. Three years later, the person who ordered it has left, and the new buyer starts again from photos.

Short answer

A repeat-order specification record keeps everything needed to order the same belt again: customer part number, machine model, approved drawing revision, material, critical dimensions with real readings, inspection report, production and installation dates, installation feedback and change history. Keep it as one record per belt, updated after every order.

At a Glance

At-a-glance summary for this buyer guide
ProductApplicationKey pointBuyer typeWhat to send
Spiral, self-stacking and process beltsRepeat orders and spare beltsOne record per belt, kept currentOEMs, distributors, maintenance, purchasingYour part numbers, machine list, and any drawings or reports you hold

Below is what a record should hold, how it builds up over the life of an order, what we keep on our side, and how the record makes the next order simple.

01What should a repeat-order specification record contain?

A record is only useful if a new person, years later, can order the same belt from it without asking anyone.

Short answer

A record should contain: customer part number, machine model and original maker, previous belt reference, supplier's internal specification, approved drawing revision, material, critical dimensions with real readings, production date, inspection report, installation date, customer feedback and change history.

Article data organised by Field, Why it is kept
FieldWhy it is kept
Customer part numberHow your plant identifies the belt
Machine model and original makerWhich machine the belt fits
Previous belt referenceWhat was replaced
Supplier's internal specificationHow the supplier identifies it
Approved drawing revisionThe single approved reference
Material and finishGrade, pickled or electropolished
Critical dimensions with readingsWhat the approved belt actually measured
Production dateWhich batch
Inspection reportReadings, photos, test video
Installation dateWhen it went into service
Customer feedbackHow it ran
Change historyEvery revision, and why

The machine maker and the previous belt reference belong in your internal record because they help identify the line. They are for your files, not for publishing.

The most valuable field is the readings. A drawing says what the belt should be. The readings say what the approved belt actually was. On the UK belt, those readings were taken at three stages — original, sample and bulk — and a repeat order would be checked against them.

02How does the record build up over an order?

A good record is not written at the end. It grows with the order, one stage at a time.

Short answer

The record starts with the machine and the old belt, gains the approved drawing and material at confirmation, the critical readings and inspection report at production, the shipping record at dispatch, and installation feedback after the belt runs. Each revision is added as it happens.

Article data organised by Stage, What is added to the record
StageWhat is added to the record
EnquiryMachine, original maker, old belt data or sample
ApprovalDrawing revision, material, special requirements
SampleReadings against the original or drawing
ProductionBatch, material record, inspection readings
ShipmentPacking photos, shipping list, spares
InstallationDate, commissioning notes, photos
ServiceFeedback, issues, changes
Repeat orderSame revision, new batch readings
  1. 01

    Customer and machine

    Who, which line, which machine.

  2. 02

    Approved drawing

    One revision, dated.

  3. 03

    Material and critical dimensions

    Grade and the readings that matter.

  4. 04

    Inspection record

    What the shipped belt measured.

  5. 05

    Installation feedback

    How it fitted and ran.

  6. 06

    Revision

    Any change, with the reason.

  7. 07

    Repeat order

    Made and checked against the record.

This mirrors how we run an order: inquiry, review, confirmation, sample, production, pre-shipment verification and delivery, each stage ending with something you can check. The stages are on our how we work page.

03What records does the supplier keep for each order?

Your record and the supplier's record should match. If they do, a repeat order is simple on both sides.

Short answer

On our side, each order is documented with the confirmed drawing, inspection records, packing photos and shipment notes, and material is recorded and traceable to the order. Repeat orders follow the recorded specification, previous shipment photos and any special requirements from the earlier order.

UK bulk belt: rod pitch 30.00 mm
UK bulk belt: rod pitch 30.00 mm
UK bulk belt: side plate thickness 1.52 mm
UK bulk belt: side plate thickness 1.52 mm
Article data organised by Record we keep, Used for
Record we keepUsed for
Confirmed drawingThe reference for production and inspection
Inspection readings, photos, videoComparing the next batch
Material recordTraceability; mill certificate support
Packing photos and shipping listWhat was sent, with which spares
Special requirementsFinish, welds, labels, packing

These commitments are written in our order control and project commitment process. On side-driven belts, a sample is also retained and the batch verified, so a re-order can be compared physically.

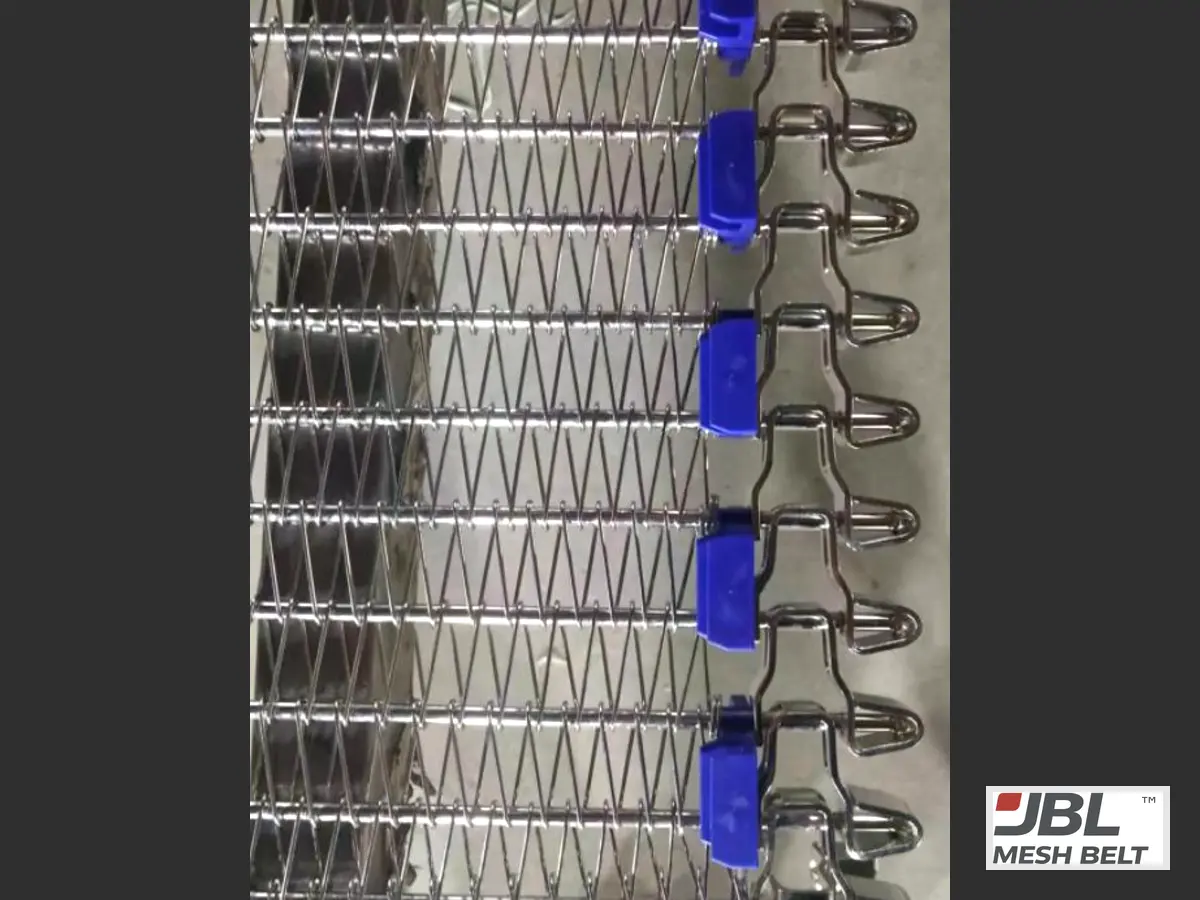

Side-driven belt: sample retained for re-orders
Side-driven belt: sample retained for re-orders
Brazil: packed with spare rods and side plates
Brazil: packed with spare rods and side plates

04How does the record make the next order the same?

With a record, a repeat order is a reference, not a new project.

Short answer

With a complete record, a repeat order quotes the part number and drawing revision. The supplier makes the belt to that revision, measures the new batch against the recorded readings, and flags any change before production. Nothing depends on memory or old photos.

Article data organised by Without a record, With a record
Without a recordWith a record
Search for old emails and photosQuote part number and revision
Re-measure the old beltCheck against recorded readings
Risk of a silent changeChanges flagged before production
New approval cycleConfirm the same revision

Brazil is the example I point to. After the first 350 m was installed, the customer ordered a second 350 m. For any repeat order like that, it helps when both sides know exactly what the first belt was.

On the UK belt, the rod pitch read 30.00 mm on the original, the sample and the bulk belt. A repeat order would be checked against those same readings.

Brazil: side plates on the turn
Brazil: side plates on the turn
Brazil: crates ready to ship
Brazil: crates ready to ship

05Who should keep the record, and where?

A record that lives in one person's inbox is not a record. It has to survive staff changes.

Short answer

Keep the record in a shared place your maintenance, purchasing and engineering teams can all reach — a maintenance system, a shared folder or your ERP — with one entry per belt. Ask your supplier to send drawings, readings and reports in a form you can file there.

Article data organised by Who, Uses the record for
WhoUses the record for
PurchasingReordering by part number and revision
MaintenanceInstallation, inspection, failure history
Engineering / QAApproving changes, checking incoming belts
Distributors and OEMsSupplying the same belt to their customers

For OEMs and distributors, the record matters even more. You may supply the same belt to many end users. A record per belt type lets you reorder, compare batches and answer your customers' questions without starting again.

If you have belts from us already, I can send the confirmed drawing or approved sample record, readings and inspection photos we hold for each order, so you can start your record from them.

Start a specification record

Send your part numbers and machine list. I send back what we hold for each belt — drawing or sample record, readings, photos — ready for your files.

Start a record →

When This Is Not the Right Choice

  • ✕If a belt is a one-off for a line that will be scrapped, a full record may not be worth the effort; keep the drawing and inspection report at least.
  • ✕If you plan to change the belt design at the next replacement, start a new record with a new revision rather than editing the old one.
  • ✕Commercial terms such as price and lead time change over time; keep them in your purchasing system, not in the technical record.

From My Engineering Experience

The repeat order is where I see whether a project was really closed well. In Brazil, the second 350 m came after the first was installed. In the UK, three stages of readings exist for anyone who orders that belt again.

What makes a repeat order easy is not memory. It is a confirmed reference — a drawing or an approved sample — real readings, and photos filed where both sides can find them.

I would like every belt we supply to have a record like this on the buyer's side too. Then the next order starts from the record, not from the beginning.

— Spring Liu, Sales Director

Evidence From Our Work

Brazil, 2025 — repeat order →

Brazil, 2025 — repeat order: project evidence summary
StepDetail
First order350 m after a 50 m trial on the freezer
InstalledReplacement completed on site
RepeatSecond 350 m ordered
PackedWith spare rods and side plates

United Kingdom, 2026 — readings at three stages →

United Kingdom, 2026 — readings at three stages: project evidence summary
StepDetail
OriginalRod 4.99 mm; rod pitch 30.00 mm; spiral pitch 8.95 mm
SampleRod 5.01 mm; rod pitch 30.00 mm; spiral pitch 9.00 mm
BulkRod 5.00 mm; rod pitch 30.00 mm; spiral pitch 9.00 mm
MaterialAISI 304 stainless steel, 450 m

FAQ

Q1What is a repeat-order specification record?

One record per belt holding everything needed to order the same belt again: part number, machine, approved drawing revision, material, readings, inspection, installation and changes.

Q2Why keep real readings and not only the drawing?

The readings show what the approved belt actually measured, so the next batch can be checked against it.

Q3What do you keep on your side?

The confirmed drawing, inspection records, packing photos, shipment notes and material record for each order.

Q4Can you send what you hold for my existing belts?

Yes. I can send the confirmed drawing or approved sample record, readings and inspection photos we hold for each order.

Q5Where should we keep the record?

In a shared system your maintenance, purchasing and engineering teams can all reach.

Conclusion

After the first good belt, keep one complete record per belt. The next order then starts from the record, not from photos.

Download the Spiral Freezer Belt Technical Specification (PDF)

Specification ranges and options in mm and inch. Enter your work email and the file downloads right away.

Download PDF →

References

Spring Liu, Sales Director at JBL Mesh Belt

Your contact for this belt

Spring Liu · Sales Director · 16 years

“Your belt is worn, the OEM price is high, and there is no drawing. That is where I start.”

Send me a worn section, a few photos with a caliper in the picture, or a drawing. I tell you what fits, what is missing, and show you a sample measured against your own belt before you pay for the full length. Buyers in the UK, the USA, Australia, Brazil, South Korea, Spain, Malaysia and Libya have replaced belts this way.

  • ✓Readings on your original next to readings on our sample
  • ✓Nothing in bulk until you approve the sample
  • ✓Turning, stacking or sprocket tests before your belt ships
  • ✓Send your drawing or old-belt photos on WhatsApp
